Excavator Bucket Sizes and Types: How to Choose

Introduction

A bucket that's too narrow, too wide, or mismatched to the material you're digging doesn't just slow you down. It burns extra fuel, chews through teeth and cutting edges faster, and can stress the excavator's hydraulics and structure enough to shorten the life of the whole machine.

Picking the right bucket isn't as simple as matching a width to a tonnage chart. Fit depends on several machine and job factors:

  • Excavator operating weight, plus hydraulic and lift limits
  • Coupler or pin setup on your stick
  • Jobsite conditions and the material you're actually moving

This guide covers standard size ranges, common bucket types, capacity math, fit checks, and the questions to ask before you buy or rent—so you match the bucket to the machine and the ground, not just a chart.

Key Takeaways

  • Treat bucket "size" as width, capacity, and weight, then match all three to your excavator's rated specs.
  • Match bucket type to the material and task, not just the hole you need to dig.
  • Choose a smaller, reinforced bucket for dense or abrasive material instead of defaulting to maximum capacity.
  • Confirm coupler fit, hydraulics, lift capacity, and wear-part availability before you buy.
  • Use manufacturer specifications for the final choice, not a generic size chart.

What Are Excavator Bucket Sizes and Types?

An excavator bucket is the attachment mounted at the end of the stick that digs, loads, grades, trenches, sorts, or otherwise handles material. When people talk about bucket "size," they might mean any of four things: inside width, volume capacity, operating weight, or the excavator class it's rated for.

That ambiguity matters. A 60-inch bucket on one machine can carry a completely different volume than a 60-inch bucket on another, depending on depth and profile. Published size ranges are useful starting points, but they vary by manufacturer, bucket design, stick length, coupler type, and the material the bucket was engineered to handle.

Common Excavator Bucket Sizes

Width and capacity are not the same measurement, and treating them as interchangeable is one of the most common sizing mistakes.

  • Width determines the trench or cut dimension — how wide a swath the bucket removes in one pass.
  • Capacity describes the volume of material the bucket can carry, which depends on depth, curve profile, and whether the rating is struck or heaped.

Caterpillar's technical specifications for its 320 excavator make this clear. On the same ~50,000-lb (22,600 kg) machine, general-duty buckets range from a 24-inch (600 mm) bucket rated at 0.72 cubic yards up to a 54-inch (1,350 mm) bucket rated at 2.08 cubic yards.

A 59-inch (1,500 mm) ditch-cleaning bucket, nominally wider, carries only 1.32 cubic yards because of its shallower profile, according to Caterpillar's 320 technical specifications.

The table below shows rough, model-specific reference points by weight class. Treat these as illustrations, not a universal rulebook:

Excavator class Reference bucket examples
Under 1 ton (micro) No verified standard width; check the specific OEM attachment guide
1–3.5 tons (mini) Ditch-cleaning/tilt buckets around 39–43 inches on Cat's 1–2-ton models
4–8 tons Finishing/ditch-cleaning buckets up to roughly 74–80 inches on some 5–6-ton models
10–15 tons General-purpose buckets often in the 900–1,100 mm (35–43 inch) range, depending on linkage
19–25 tons General-duty buckets from about 24 to 54 inches, 0.72–2.08 cubic yards on the Cat 320

None of this replaces checking the OEM's approved attachment range for your specific machine and stick configuration.

Common Excavator Bucket Types

Different jobs call for different cutting geometry. Here's how the main categories break down:

  • General-purpose (GP) digging buckets — flat-bottom design with teeth for soil, sand, gravel, and topsoil. EFI stocks options like the JISAN CAT 395, an 8.5-cubic-yard GP bucket for 160,000-lb-plus excavators.
  • Grading, ditching, and cleanup buckets — wider and shallower, with a smooth or straight edge for slope shaping, ditch cleaning, and backfilling rather than aggressive digging.
  • Trenching and micro-trenching buckets — narrow profiles that set a controlled trench width for utilities, drainage, irrigation, or fiber. Width must match the required trench dimension exactly.
  • Heavy-duty, severe-duty, and rock buckets — reinforced shells, abrasion-resistant steel, upgraded teeth, and side cutters for hard-packed soil, rock, and concrete debris. EFI's JISAN CAT336 rock bucket pairs a deep reinforced shell with a 77-inch cutting edge for abrasive work.
  • Specialty buckets — tilt/angle for slopes, skeleton/riddle for sorting debris, frost/hard-pan for frozen ground, and V-shaped for drainage ditches.

These aren't interchangeable. A tilt bucket won't out-dig a heavy-duty digging bucket in rock, and a skeleton bucket has no business in a fine-grading application.

What to Consider When Choosing the Best Excavator Bucket

Selection should start with the work itself, then move through material, machine limits, dimensions, capacity, attachment fit, and total cost. Each factor below connects directly to cycle time, fuel use, wear-part life, and downtime.

Job Type and Required Bucket Profile

Match the bucket to the primary task: digging, trenching, loading, grading, ditch cleaning, sorting, or demolition cleanup. Using a grading bucket for deep excavation reduces penetration and control. Using a general-purpose bucket on abrasive rock wears it out fast and slows production.

Material Type, Density, and Abrasiveness

Loose soil, clay, sand, gravel, rock, and concrete rubble don't fill a bucket the same way. Caterpillar's Performance Handbook lists fill factors from 100–110% for moist loam or sandy clay down to 40–50% for poorly blasted rock. That swing changes how much real volume a given bucket delivers each cycle.

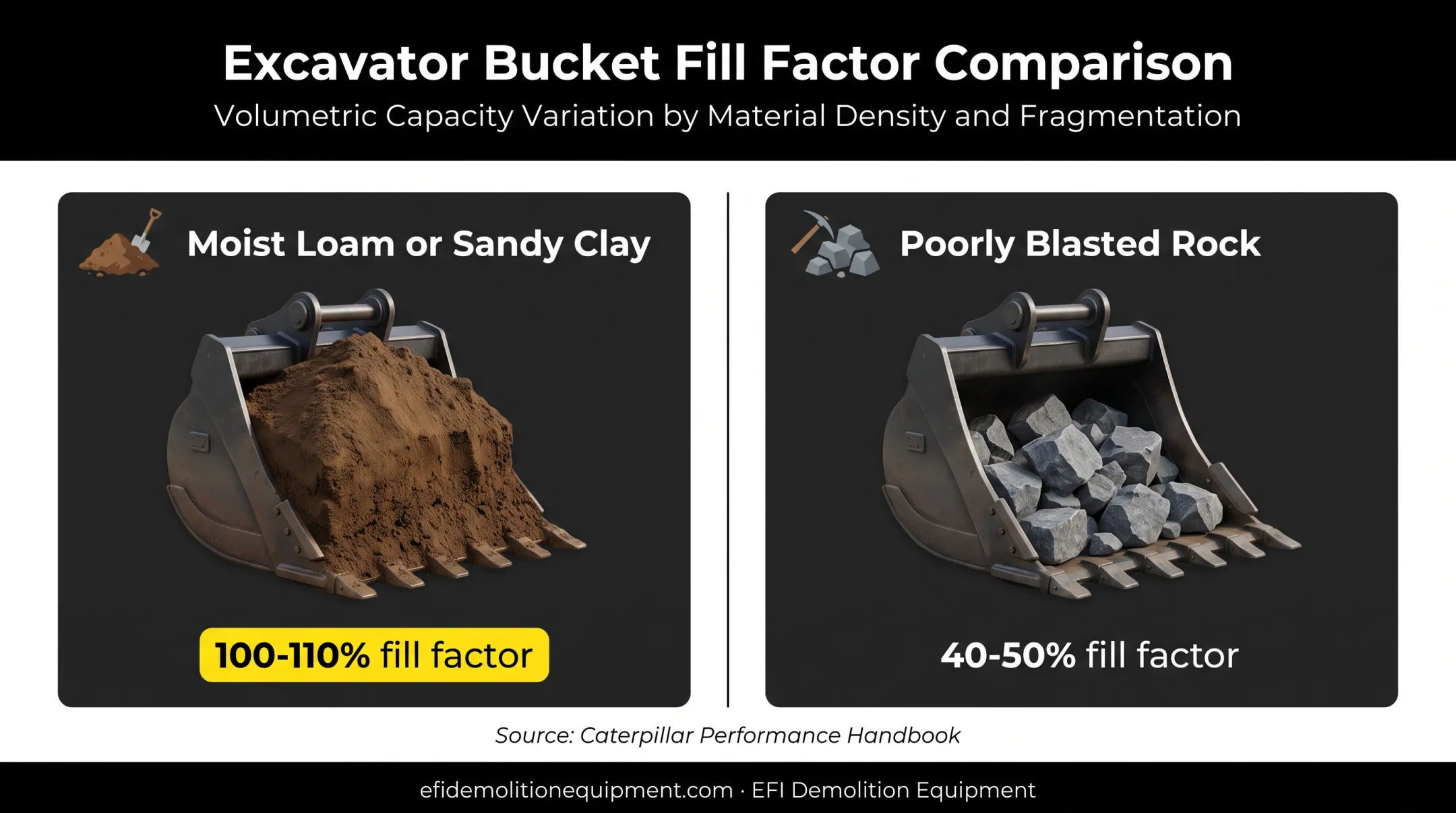

Excavator bucket material fill factor comparison by soil type

When material is unusually dense or abrasive, go smaller and more reinforced rather than bigger and standard-duty. A smaller heavy-duty bucket often outproduces an oversized general-purpose one on rock or demolition debris.

Excavator Operating Weight and Lift Capacity

A bucket has to be approved for the excavator's operating-weight class. Bucket weight itself counts against payload, and boom reach, stick length, and other attached tools all affect what's safe to lift. Always verify the OEM lift chart for the specific configuration. There's no universal bucket-to-machine ratio that works across brands or models.

Bucket Width, Depth, and Required Geometry

Trench width, working clearance, excavation depth, slope angle, and truck loading height all shape which bucket geometry works. A wider bucket cuts down on passes in open excavation. It can still be the wrong choice for narrow utility work, confined sites, or dense material that a wide bucket can't break out efficiently.

Attachment Interface and Hydraulic Compatibility

Pin diameter, pin centers, ear width, coupler type, and any tilt or thumb mechanism all need to line up with the excavator. Before purchase, compare the bucket's fit data against your excavator's serial number, model, stick, and coupler specs. This is where custom mount-and-pin fabrication earns its keep. EFI's fabrication shop builds mounts, pins, and couplers for machines that don't match an off-the-shelf listing, often with same-day turnaround.

Wear, Maintenance, and Lifecycle Cost

Inspect teeth, adapters, side cutters, cutting edges, wear plates, welds, bushings, pins, and structural cracks, whether the bucket is new, used, or a rental. The initial price tag is only part of the equation:

  • Replacement-part availability affects how long the bucket stays in service.
  • Repairability determines whether damage means a repair bill or a full replacement.
  • Rental versus purchase changes the math depending on how often you'll use that specific bucket.
  • Downtime from a mid-job failure usually costs more than the gap between a solid bucket and a cheap one.

How to Match Bucket Capacity, Machine Limits, and Job Requirements

Bucket capacity gets reported two ways: struck capacity, the volume level with the bucket's top edge, and heaped capacity, which includes material mounded above that edge.

ISO 7451:2007 sets the conventional method for these ratings, but it explicitly states the result is for comparison purposes, not a guarantee of what a bucket carries on a given site, per ISO's standard for excavator bucket volumetric ratings.

Manufacturer capacity data beats estimating from raw dimensions, since bucket profiles are curved and actual fill depends on material and operator technique.

A Practical Bucket-Capacity Calculation

Here's the general sequence for sizing a bucket to a production target:

  1. Identify the production target — how much material needs to move per hour or per shift.
  2. Determine material density and fill factor — using manufacturer data rather than guesswork.
  3. Measure or estimate cycle time — how long one dig-swing-dump cycle takes on your site.
  4. Calculate payload per cycle — bucket volume multiplied by fill factor gives average payload per pass.
  5. Select a bucket capacity that hits the target without exceeding the machine's rated limits.

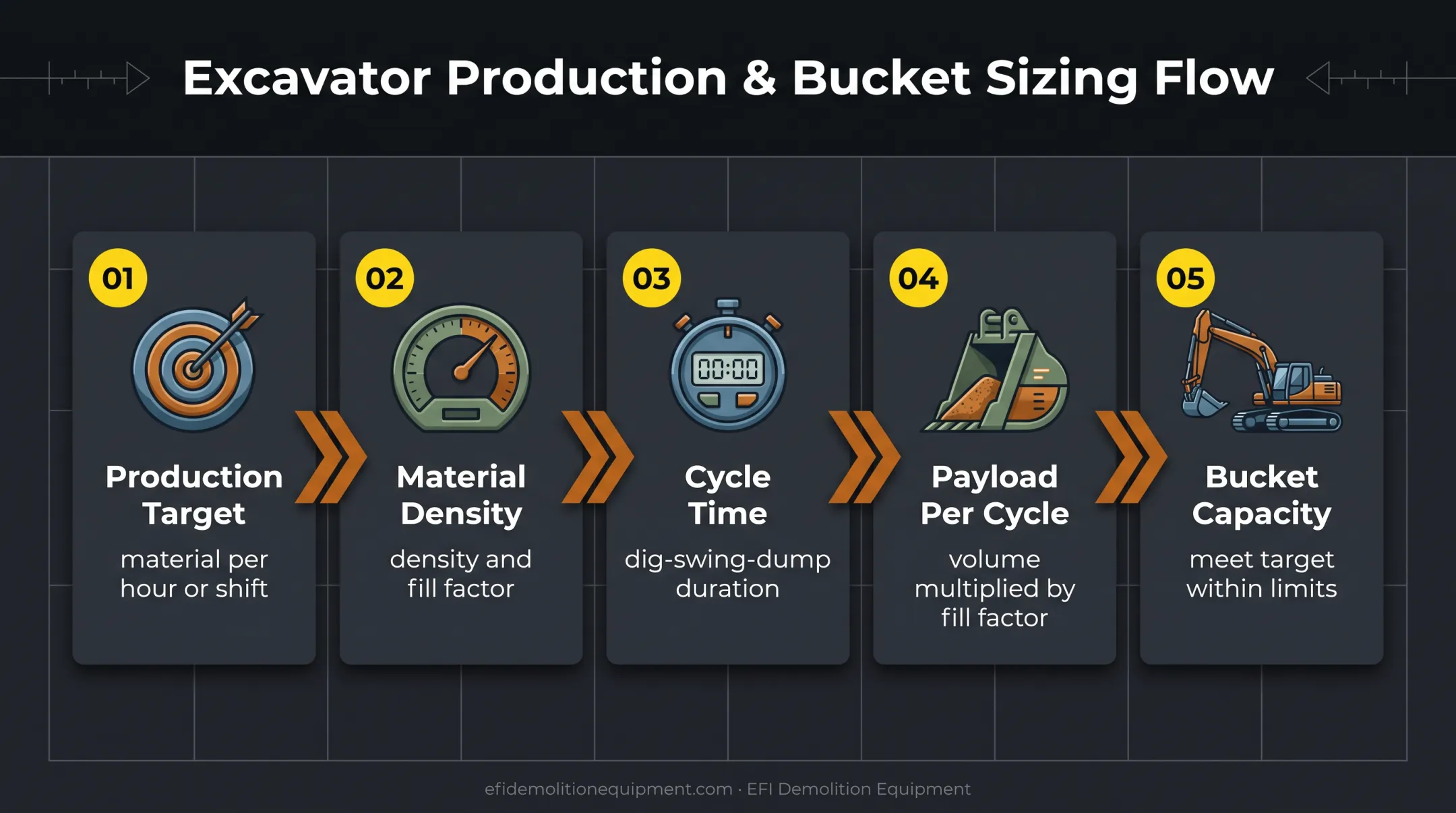

Five-step excavator bucket capacity calculation process

A 60-inch bucket can't be assigned one universal cubic-yard figure. As the Cat 320 and 330 spec sheets show, a 60-inch ditch-cleaning bucket, a 60-inch tilting ditch-cleaning bucket, and a 60-inch general-duty digging bucket carry different rated volumes on the same excavator family.

Always check the specific bucket's listed capacity and profile.

Safety and Productivity Checks Before Operating

Before putting a new or unfamiliar bucket to work, confirm:

  • The excavator's rated lift capacity, bucket weight, and payload
  • Coupler engagement and hydraulic settings
  • Ground stability and operating radius
  • Teeth, welds, and pin or coupler locks are intact
  • Smooth, controlled bucket movement before anyone works nearby

Oversizing a bucket doesn't just risk instability. It slows cycles, weakens breakout force, and adds structural and hydraulic stress that accelerates wear across the whole machine.

Choose for the Whole Job, Not One Pass

The best bucket balances production rate against truck or stockpile loading needs, site access, fuel use, and how often you'll switch materials or tasks mid-project.

For demolition and recycling crews specifically, a standard heavy-duty bucket handles routine debris loading fine. But once you're separating rebar from concrete, screening topsoil, or sorting mixed rubble, a screening or crushing bucket, grapple, or pulverizer often outperforms a standard bucket.

EFI's screening and crushing bucket line, for example, runs on 25-ton to 90-ton excavators with screen sizing from 1/8 inch to 4 inches. These attachments are built for material sorting rather than straight digging.

How EFI Demolition Equipment Can Help

Choosing between a general-purpose bucket, a rock bucket, and a screening bucket gets easier with someone who's matched thousands of attachments to machines.

EFI Demolition Equipment, based in DeRuyter, New York, has spent over three decades supplying demolition equipment, attachments, rentals, parts, and custom fabrication to contractors across the U.S. and internationally.

EFI works through the same variables covered in this guide: excavator model, attachment interface, application, material, duty level, and how fast the job needs to move. That process shapes what gets recommended, not a one-size-fits-all chart.

EFI custom fabrication team preparing excavator attachment fitment

A few things that make the process smoother:

  • Custom-fabricated mounts and pins built in-house for machine-to-attachment fit, often ready within a day
  • 12-point inspection on every unit before it ships
  • Upfront pricing with no hidden fees
  • Same-day support when something breaks mid-job
  • Sales and rental options across 2,500+ units and 30+ brands

When you request a recommendation, have these details ready:

  • Excavator make, model, and serial number
  • Operating weight
  • Coupler or pin dimensions
  • Target material and desired bucket width

Those specifics turn a generic conversation into a clear fit.

Conclusion

The right excavator bucket is the one that safely matches your machine, material, and production target—not the widest option or the highest capacity rating alone.

Before you buy or rent, run through these checks:

  • Confirm the bucket type fits the task
  • Verify width and capacity against manufacturer data
  • Check lift and hydraulic limits
  • Inspect fit and wear components
  • Follow OEM operating guidance

Weighing bucket options, need custom fitment, or comparing rent versus buy? Call EFI Demolition Equipment at 315-440-2762 with your excavator specs for a faster fit and options review.

Frequently Asked Questions

What are the standard sizes of excavator buckets?

Standard widths vary by excavator class and bucket type. There's no single universal chart. Check a current manufacturer size chart for your specific model, since even buckets with matching widths can carry different rated capacities.

What size bucket comes on a mini excavator?

Mini excavators typically use narrow digging and trenching buckets alongside wider grading or ditch-cleaning buckets, spanning roughly 39 to 80 inches depending on the model. The exact bucket supplied depends on the machine, the task, and the manufacturer's offering.

What size bucket does a 20-ton excavator typically use?

On Caterpillar's 320, a popular 20-ton-class machine, general-duty buckets range from about 24 to 54 inches wide, rated between 0.72 and 2.08 cubic yards. Always confirm the approved width, capacity, and coupler fit for your specific machine configuration.

What is the bucket capacity of a 30-ton excavator?

Capacity varies significantly by bucket width, depth, profile, and whether the rating is struck or heaped. On Caterpillar's 330, general-duty buckets alone range from 0.68 to 2.43 cubic yards depending on width. Check your excavator and bucket manufacturer's data directly.

How do you calculate excavator bucket size?

Start with the task and trench dimensions, then check machine limits. From there, factor in bucket weight, material density, fill factor, cycle time, and your production target against manufacturer capacity data to land on the right size.

How many cubic yards is a 60-inch excavator bucket?

Width alone doesn't determine capacity. A 60-inch bucket's cubic-yard rating depends on its depth, profile, and whether it's struck or heaped. Always check the specific bucket's listed manufacturer specification.
