House Demolition With Excavator Tearing down a house looks simple from the street: big machine, swinging arm, pile of rubble. In practice, a botched teardown means collapsed walls landing the wrong direction, severed gas lines, air quality violations, or a tipped excavator sitting in what used to be a basement.

Hydraulic excavators have become the standard for residential demolition because a single carrier can handle roof removal, wall collapse, concrete breaking, and site grading just by swapping attachments. That versatility is also why so many projects go sideways. Success depends on matching the right machine and attachment to the structure, not just pointing a boom at a wall.

This guide walks through when mechanical demolition makes sense, what you need before breaking ground, a step-by-step teardown sequence, the operating variables that actually move the needle, and the mistakes that cause most on-site failures.

Key Takeaways

  • Size the carrier to the structure: 1–3 ton minis for sheds; 15–25 ton machines for multi-story framing.
  • Document utility disconnects, asbestos clearance, and permits before the boom moves.
  • Sequence top-down and inside-in to steer collapse and keep debris off neighboring property.
  • Match breakers, grapples, and pulverizers to each teardown stage to cut job time.

How to Demolish a House Using an Excavator

House demolition with an excavator follows a controlled top-down sequence. Each phase below protects the crew, neighboring property, and the machine.

Step 1: Site Prep, Abatement, and Utility Disconnection

Before the excavator touches the structure, confirm every utility is physically severed and capped at the street line, not just switched off at the meter. OSHA's demolition standard requires gas, electric, water, and sewer lines to be shut off, capped, or otherwise controlled outside the building line, with the utility provider notified in writing. A competent person must also complete an engineering survey of the structure's condition before work begins [1]. Other pre-demolition hold points:

  • Asbestos clearance: Federal NESHAP rules generally exempt stand-alone homes with four or fewer units, but state and local asbestos rules often still apply. Get a written inspection report before disturbing anything.
  • Permits posted: Municipal demolition permits and any required notification periods (some jurisdictions require a 10-day asbestos notice window regardless of findings) should be on file.
  • Exclusion zone: Set a restricted perimeter based on the structure's actual collapse and swing-radius hazards, not a guess. Install silt fencing and stage water hoses for dust suppression.
  • Machine inspection: Check track tension, FOPS/FOGS cab guarding, hydraulic fluid levels, and attachment pin security before startup.

Step 2: Roof Removal and Upper Story Teardown (Top-Down Sequence)

OSHA requires exterior-wall and floor demolition to begin at the top and move downward, with supporting floor members left intact until everything above has been cleared [1]. For a house, that means the excavator punches through the roof ridge or pulls trusses first, rather than letting gables collapse uncontrolled. Keep the boom positioned to pull rafters inward toward the center of the footprint, not away from it. Working this way:

  • Reduces the chance of debris falling outside the exclusion zone
  • Keeps the operator's standoff distance consistent as the roofline opens up
  • Lets ground crew apply continuous water spray at the point of contact to limit airborne dust Switch between a heavy-duty bucket for bulk roof decking and a hydraulic grapple when you need to separate metal flashing, shingles, and framing lumber. A grapple bucket like EFI's 2018 SEC 42-inch unit, built with an open-grid design for sorting demolition debris, speeds this stage compared to a solid bucket.

Step 3: Exterior Wall Collapse and Interior Partition Processing

Once the roof is down, shift to the walls using an outside-in approach: peel exterior framing inward toward the building's center rather than pushing it outward toward property lines or neighboring structures. Weaken load-bearing corners methodically so walls drop inside the basement or slab perimeter instead of falling unpredictably. As walls come down, sort materials immediately rather than stockpiling mixed debris:

  • Framing lumber and dimensional wood: staged separately for C&D recycling
  • Drywall: kept out of metal and concrete piles
  • Wiring and conduit: pulled clear before it tangles in the grapple
  • Structural steel: set aside for scrap value Watch for structural binding during this phase. Hidden steel ties, continuous headers, or interlocked trusses can resist a single pull and whip back without warning. Flexed rebar or framing that springs free during cleanup is a documented cause of jobsite injuries.

Step 4: Foundation Breaking, Slab Removal, and Final Site Grading

With the structure cleared, swap the grapple for a hydraulic breaker or concrete pulverizer to fracture footings, basement walls, and slabs. Carrier-to-attachment matching matters most here. A pulverizer like the 2020 Mustang FH15 (4,050 lb, fits 30,000–70,000 lb excavators) needs the carrier's auxiliary circuit tuned to the attachment's rated flow and pressure, or cycle times suffer. After breaking:

  • Pry and load fractured concrete, separating embedded rebar to maximize scrap value and avoid landfill contamination penalties
  • Inspect the subgrade for buried pipes or septic infrastructure before backfilling
  • Backfill basement cavities with clean fill, compacting in lifts
  • Finish with a wide grading bucket to leave a level, build-ready site

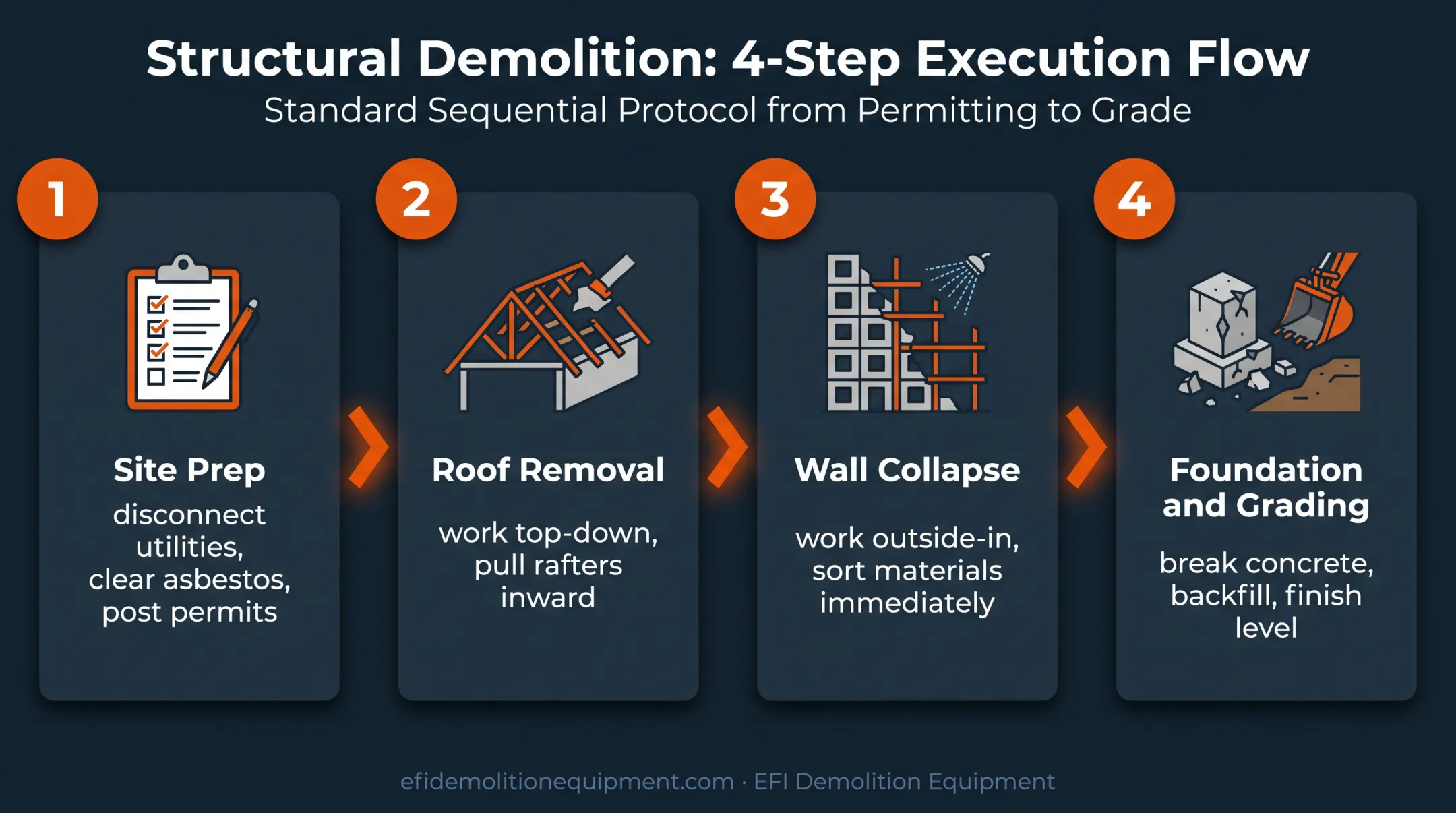

Four-stage excavator house demolition sequence from roof to grading

When Should You Demolish a House Using an Excavator?

Mechanical excavator demolition is the fastest, most cost-effective method for most residential teardowns — provided the site and structure allow it. It works well for:

  • Full residential teardowns where the lot has clear equipment access on at least one side
  • Fire-damaged property clearing, where speed matters more than material salvage
  • Partial removals like attached garages or additions, where boom reach and control let you demolish one section without touching the rest

It's the wrong tool when:

  • Historic districts that require manual deconstruction or architectural salvage
  • Zero-lot-line townhouses sharing party walls with occupied neighbors
  • Crane-only easements or tight lots with no room for a carrier to maneuver

Before committing to a standard excavator, check these site conditions:

  • Soil bearing capacity near the foundation
  • Overhead utility clearance for the boom's working arc
  • Slope stability where the tracks will sit

A machine that can't get solid footing near an open basement excavation creates a real tip-over hazard.

What You Need Before Demolishing a House Using an Excavator

Preparation, not horsepower, decides whether a demolition job stays safe, legal, and profitable.

Equipment and System Requirements

Excavator sizing should follow the structure, not the other way around:

Structure type Recommended carrier weight Notes
Sheds, small outbuildings 1–3 ton mini Tight access, light breakout force
Single-story homes, tight lots 3–8 ton compact/midi Good reach-to-footprint ratio
Two-story homes, masonry foundations 15–25 ton mid-size Reach and breakout force for upper floors

Beyond the carrier, plan on task-specific attachments:

  • Hydraulic breakers for slab fracturing
  • Grapples for sorting debris
  • Pulverizers for concrete and rebar separation

EFI Demolition Equipment stocks hammers from roughly $10,800 to $42,000, depending on impact energy and carrier size. That includes grapples such as the JISAN JXJMQC315 (for 12–18 ton excavators) and custom-fabricated mounts and pins for carriers from 35,000 to 110,000 lb when an attachment does not natively fit your machine.

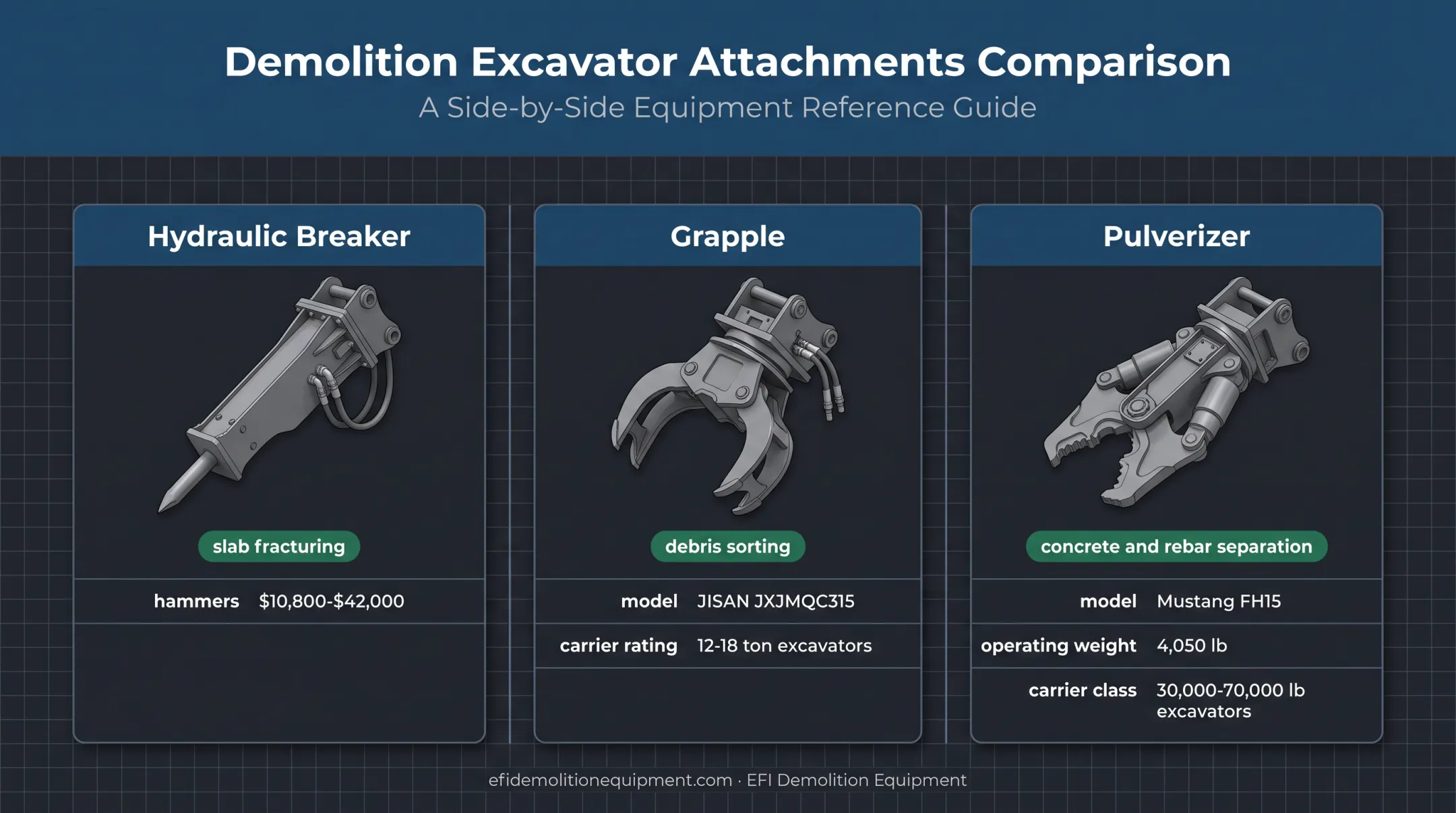

Excavator demolition attachment comparison with carrier sizes and prices

Inputs, Materials, and Site Conditions

  • Pressurized water hookups or a water truck for dust control in every phase
  • Staged roll-offs or dump trucks split by stream (concrete, metal, wood C&D) to limit cross-contamination
  • Confirmed utility disconnects before the first cut or pull

Skill, Safety, and Compliance Readiness

  • Operator certifications and documented OSHA demolition training
  • A completed job hazard analysis (JHA) before mobilization
  • PPE for every person on site: NIOSH-approved respirators, high-visibility apparel, steel-toe boots, eye protection, and hard hats

Key Parameters That Affect Results

A handful of operating variables determine whether a teardown goes smoothly or turns into a slow, expensive mess.

Machine Reach and Operating Radius

Boom and stick reach decide whether the operator can access roof peaks and second stories while staying clear of the active collapse zone. Published specs can be misleading here: a Cat 320's maximum reach figure, for example, reflects ground-level dig reach, not elevated demolition reach.

Insufficient working distance forces the machine too close to unstable walls, raising tipping risk and falling-debris exposure.

Hydraulic Flow and Operating Pressure

Attachments like hydraulic breakers need precise flow (gallons per minute) and pressure matching with the carrier's auxiliary circuit. Epiroc's MB 1200 breaker, for instance, specifies a 15–26 metric-ton carrier with 26.4–37 gpm flow and 2,320–2,610 psi operating pressure [2].

Mismatch those numbers and you get sluggish cycle times, attachment overheating, or hydraulic pump cavitation. All of that slows the job and wears out components early.

Debris Management and Live Sorting

Sorting materials during teardown, not after, keeps recyclable streams clean. Separately sorted concrete has historically cost far less to dispose of than mixed demolition debris in cost studies. That gap is worth capturing on every job through live sorting rather than a single mixed pile [3].

Ground Stability and Machine Positioning

Operating near open basement excavations or soft backfill risks track displacement. Keep idlers facing the work and tracks perpendicular to the excavation edge to maintain stability under dynamic shock loads. Never assume backfilled soil near a foundation wall will hold a 15-ton machine without settling.

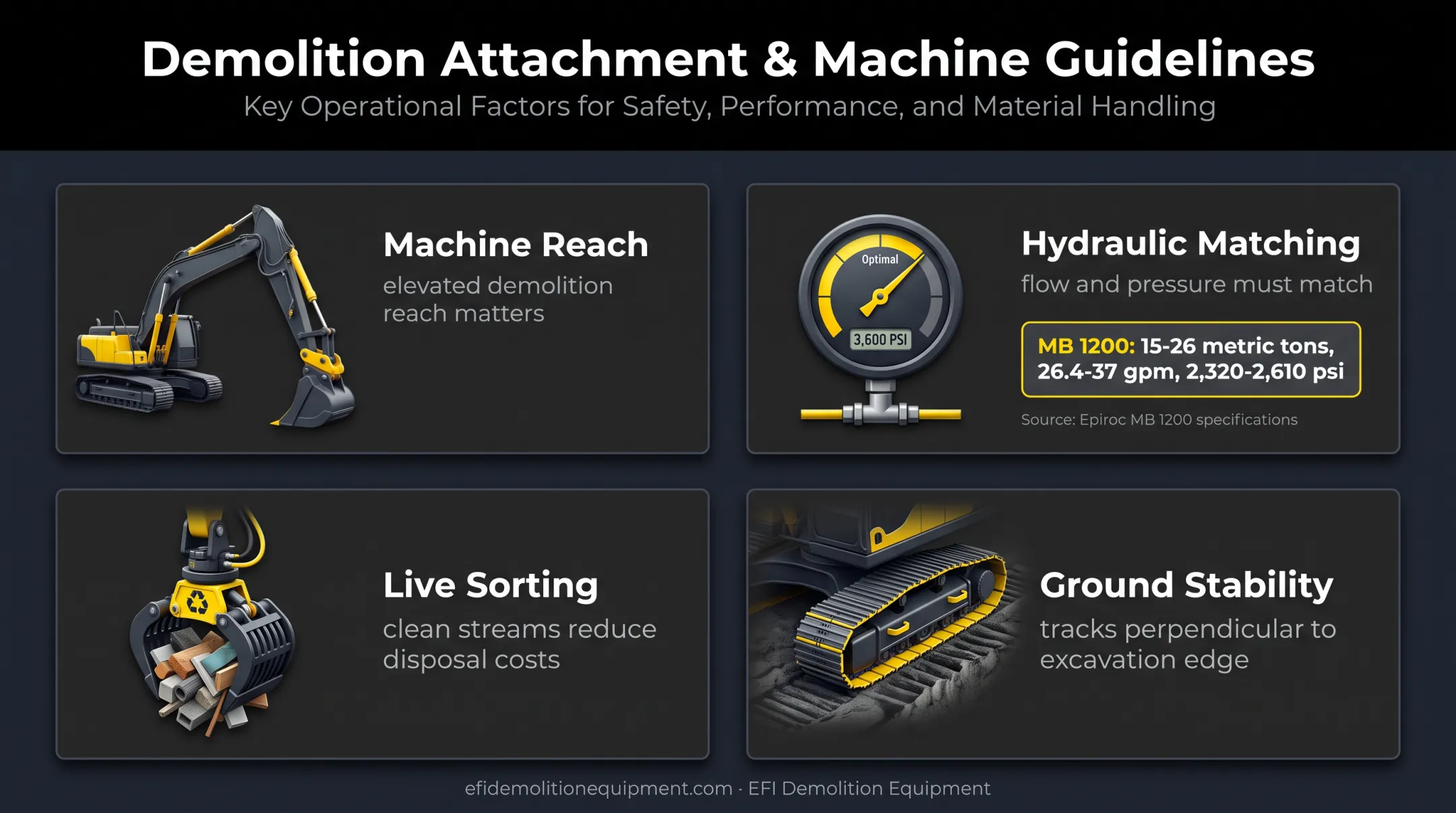

Four excavator operating variables affecting demolition safety and performance

Common Mistakes When Demolishing a House Using an Excavator

Most residential tear-downs go wrong in the same few places. Avoid these:

  • Skipping a documented physical disconnect certificate and treating an 811 locate as enough
  • Pushing walls outward instead of pulling them inward into the footprint, risking damage to adjacent property
  • Undersizing the excavator or running attachments past the carrier's hydraulic capacity and lifting envelope
  • Failing to suppress dust with continuous water mist, which invites air quality violations and neighbor complaints

Troubleshooting Issues While Demolishing a House With an Excavator

Even experienced crews hit snags mid-demo. Use this quick reference when walls bind, breakers lose power, ground shifts, or hydraulics overheat.

Problem Likely Cause What to Check or Adjust
Structural hang-ups or uncontrolled wall binding Continuous headers, steel ties, or interlocked trusses resisting a single pull Reposition the boom; switch to a shear or toothed bucket; sever anchor joints instead of pulling harder
Breaker losing impact power Low auxiliary flow, wrong backpressure, worn bushings, or depleted nitrogen accumulator Check auxiliary valve settings; confirm full quick-coupler engagement; review attachment maintenance history
Ground subsidence or track slippage near basement cavities Excess soil loading near unstable foundation walls or collapsing sub-slab voids Swing the boom away from the edge; track back on mats or steel plates; backfill voids before continuing
Overheating hydraulics under heavy duty cycles Continuous hammering, dust-clogged coolers, or low reservoir levels Clean cooler fins with compressed air; check the reservoir sight glass; allow cooling intervals between breaking passes

Alternatives to Demolishing a House Using an Excavator

Standard excavator teardown isn't always the right fit. These three approaches cover the most common cases where a standard machine is the wrong primary tool:

Approach When It's Better Trade-Off
Manual deconstruction and hand salvage Historic preservation, architectural salvage, high-value reclaimed lumber Weeks instead of days; often 17–25% higher cost than demolition
High-reach demolition excavators Multi-story homes or steep hillside builds beyond standard boom reach Higher mobilization cost, larger site footprint, specialized operator certification
Compact track loader interior gutting before teardown Urban row homes with shared party walls, tight lots with no room to swing 360° Slower cycle times; still needs an excavator for deep footing removal

Conclusion

Excavator-based demolition delivers speed and debris control when the groundwork is done right. Most failures trace back to the same root causes:

  • Skipped utility checks
  • Undersized machines paired with oversized attachments
  • Rushed collapse sequencing that ignores top-down, inside-in principles

Get the carrier sized correctly, match attachments to hydraulic specs, and follow a disciplined sequence from roof to foundation. Done that way, a teardown stays safe, compliant, and on schedule.

Frequently Asked Questions

What is the best way to demo a house?

Mechanical demolition with a properly sized excavator, matched hydraulic attachments, and top-down sequencing is the fastest and most cost-effective method for residential structures. Manual deconstruction only makes sense when material salvage justifies the extra time and cost.

What is the best size excavator for residential demolition?

Single-story homes and tight suburban lots typically need a 5–10 ton compact or midi excavator. Standard two-story homes and heavy masonry foundations call for a 15–25 ton mid-size carrier for adequate reach and breakout force.

Can a mini excavator break up concrete?

Yes. Mini excavators fitted with a matched hydraulic breaker can handle walkways, patios, and light residential slabs up to 4–6 inches thick. Heavier commercial footings require larger tonnage machines.

What are the three types of demolition?

The three main categories are total mechanical demolition (excavators and heavy equipment), selective or interior demolition (gutting specific sections), and manual deconstruction (hand-dismantling for salvage and recycling).

How long does it take to demolish a house with an excavator?

Structural teardown of a standard 1,500–2,500 square foot home typically takes 1 to 3 days. Foundation removal, material sorting, and final grading extend the schedule.

Do you need a permit to demolish a house with an excavator?

Yes. Municipal demolition permits, utility disconnect sign-offs, and environmental abatement clearances like asbestos inspection reports are legally required before mechanical demolition can begin.
